    Commissioning of large WWTP with flat sheet MBR technology

    平板膜生物反應器應用于大型污水處理廠的調試運行

    2014-05-29 Gasull 水進展

    Introduction

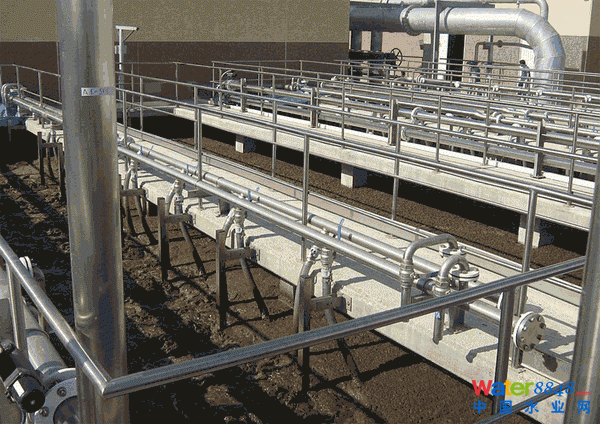

    Figure 1: Arenales del Sol WWTP

    The Arenales del Sol WWTP, located in Alicante in the Mediterranean region of Spain, combines biological treatment with nutrient removal with a submerged MBR system fitted with flat sheet (FS) ultrafiltration membranes, with an average treatment capacity of 10,000 m3/d (10 MLD). The plant provides high quality treatment to highly variable seasonal sewage inflow due to the nature of this popular coastal region, where second homes and golf courses attract visitors during the summer months and winter and Easter vacation periods.

    This seasonal feature became a major challenge during the commissioning of this relatively large MBR plant in a short space of time and with very little contingency, demanding specific operational strategies.

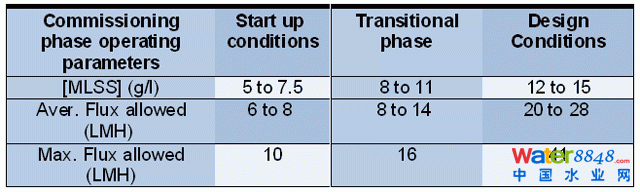

    Figure 2: Specification – Arenales del Sol WWTP

    Typical commissioning challenges of an MBR

    Many WWTPs fitted with MBR technology have experienced severe difficulties during the commissioning and start-up phases of the project, specifically because operational problems are normally manifested as failure to meet the hydraulic load, rather than achieve the required level of purification. This demands that membrane fouling and clogging is minimised as much as possible, through removal of fine solids and reduction of EPS or dissolved organic carbon levels in the sludge. Also, the variation of operational parameters such MLSS concentration, peak fluxes and aeration volume are known to exacerbate fouling and clogging, as well as the sludge floc structure.

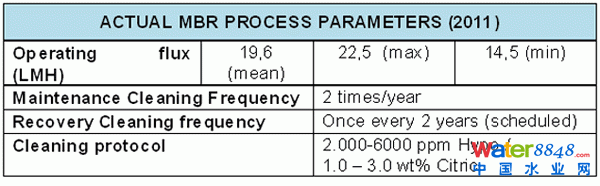

    Figure 3: Actual MBR process parameters

    Various challenges arise during MBR commissioning, including:

    • rapid membrane fouling due to insufficient biomass concentration, unhealthy micro-organism populations, excessive EPS formation or membrane blocking

    • overflowing tanks from heavy foaming events (with subsequent biomass loss) or membrane clogging

    • under-spec treated water quality prior to the biological conditions reaching the design values, and specifically the MLSS concentration

    • impaired treatment from incomplete tasks from commissioning, such as clean water testing, PID control adjustment, etc

    • membrane clogging or ragging due to unscreened seeding sludge

    • membrane damage due to abrasion from construction materials, such as metal shards from thread tapping not removed from the MBR tanks

    • sludge settling due to blower failure

    • membrane over- or under-aeration due to incomplete PID blower testing or incorrect blower design.

    All the activities planned for the commissioning of this WWTP aimed to minimise or avoid the above, by applying knowledge available from a number of published case studies.

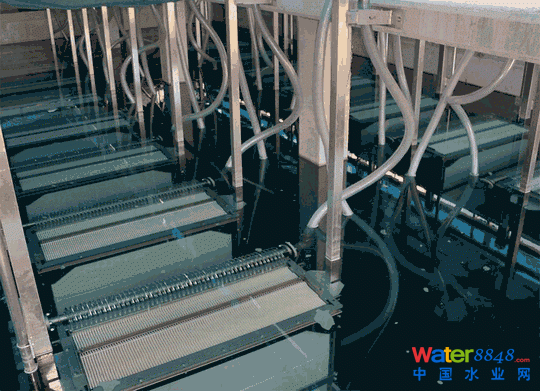

    Figure 4: The MBR tanks at Arenales del Sol WWTP

    Commissioning requirements, hollow fibre versus flat sheet systems

    Sludge seeding in biological and MBR tanks can become challenging in medium to large municipal WWTPs. Typically, the anoxic and oxic reactor volumes are usually too large and unchambered to be filled with rather concentrated sludge from other WWTPs in a single step. Equally difficult and expensive is to truck in excess recirculation sludge from other secondary decanters to achieve a high MLSS concentration in the MBR tanks.

    On-site biomass augmentation is thus unavoidable for any medium to large MBR plant, and the target MLSS concentration will depend on the membrane configuration: 5-8 g/l (or 10-12 g/l for short periods) for an HF configuration compared with 12 to 15 g/l for the FS. It follows that target biomass conditions are more rapidly attained for HF systems. Moreover, as often observed in MBR literature, FS membranes experience major fouling at lower MLSS from small pin-floc structures causing rapid pore blocking more rapidly. At higher MLSS levels and correspondingly larger flocs, the sludge-scouring air mixture provides greater higher shear and so an improved cleaning efficiency at higher MLSS concentrations (up to 18 g/l) than at lower.

    In the case of HF systems, the initial MLSS concentration is not considered as important during commissioning, since they demonstrate good best filtration performances at sludge seeding concentrations (2 to 6 g/l).

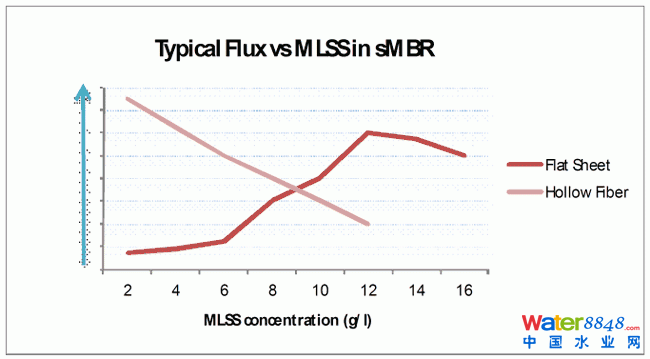

    Figure 5: Typical flux versus MLSS in sMBR

    Figure 6: Clean water testing

    It was important to reduce the risk of initial fouling at the low MLSS concentrations to avoid downtime for chemical cleaning. However, since the existing WWTP was not meeting effluent discharge standards, the new plant had to be ready for work with full flow treatment warranties in a shortened time. Given the time constraints the project was under, a minimum MLSS concentration of only 6-7 g/l was deemed necessary prior to operation with the FS MBR membranes.

    All ancillary equipment to the MBR (blowers, pumps, PLC, etc) was fully tested with clean water.

    Fouling control strategies during start-up: Biomass development

    Biological degradation of the sludge in the reactors is required not only to meet effluent discharge standards but also to avoid membrane fouling by excessive unoxidised BOD levels. Time restrictions associated with the commissioning required both a stable biomass and a ready-for-business MBR system at the design conditions of 12.5-15 g/l within 8-10 weeks.

    Unfortunately, since only about 30% of design inflow was being received at the time, there was a shortage of carbon for natural bio-augmentation. Biomass augmentation was thus achieved using the anoxic and oxic tanks in one (of two) of the treatment lines in an sequencing batch mode, with supernatant being regularly withdrawn so as to increase the MLSS without decharging the solids (thus increasing the SRT).

    The plant was fed both with untreated sewage pumped from the existing plant at a reduced loading rate and sugar cane residues as an additional carbon source. Additionally, small volumes of hydrophyliced bacteria were added in the first few days to rapidly increase the available micro-organism population in the tanks. This strategy allowed for a controlled seeding process while closely examining biomass species under the microscope.

    All sludge fed into the new plant was mesh filtered in the new rotary drum screens (punch-hole, 1mm) for failsafe operation of the membranes.

    Modelling software (WEST) was used to simulate biomass growth in the biological tanks. As it turned out, WEST predictions were quite accurate in assessing the actual biomass growth rate during start-up. The time employed in seeding and concentrating the sludge was used to calibrate the input data for the modelling software.

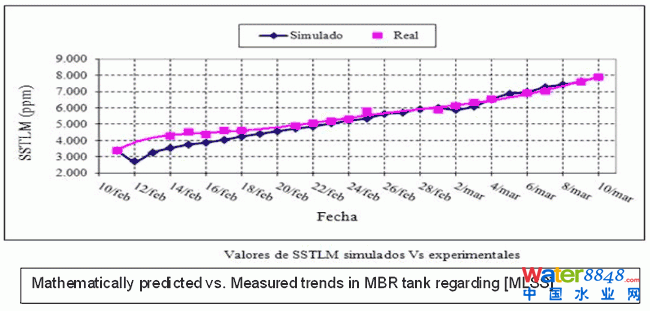

    Figure 7: Mathematically predicted versus measured trends in MBR tank regarding [MLSS]

    Fouling control strategies during start-up: Flux control

    Flux control is crucial for fouling control. It is well known that if flux is maintained below a certain critical value (known as critical flux), it is possible to ensure stable operation with little or negligible increase in TMP for longer periods, and hence reduce cleaning frequency. It is also true, however, that this critical flux is unique to every MBR plant and process water characteristics, and it is usually only ascertained through trial and error experimentation under design operational conditions (in this case, 12.5 g/l at 22-28 LMH). Strict flux control during commissioning stage is thus essential to avoid accelerated fouling, particularly when using FS system configurations.

    Flux values employed prior to reaching the design conditions were kept conservative, particularly at around 6-7 g/l MLSS when operation was kept well below the critical flux. Average biomass temperature at start-up was slightly above 16ºC.

    Since commissioning time was getting closer and filtration had to be resumed promptly prior to the Easter vacation period, filtration was started with a low MLSS of 6.5 g/l and a flux below 8 LMH, with a maximum allowed emergency flux of 10 LMH. The operational flux allowed at each of the commissioning phases (see below) was chosen according to previous experiences with the chosen membrane technology.

    Figure 8: Operational flux at each of the commissioning phases

    This filtration time prior to commissioning, even at these low fluxes (design flux was 22 LMH) allowed for both biomass concentration and biomass acclimatation while reaching the more acceptable MLSS levels above 10 g/l. Again, the WEST modelling software was employed to forecast biomass growth and hence inform the initiation of full-flow start-up of the plant.

    Fouling control strategies during start-up: Air scouring control and optimisation

    The beneficial effects of air scouring to control fouling at the membrane surface of flat sheet membranes is well documented. Typically, it is assumed that there is a linear relationship between membrane flux (Lwater/m2/h) and the air scouring rate (Nm3/h/m2), within some limits above which this positive influence of higher air volume per unit membrane area is no longer observed. The designed air scouring range for the membranes was from 0.42-0.6 Nm3/h/m2 – typical for a double-deck Toray system.

    Initially, the MBR control system had been programmed so as to reduce the energy consumption related to air scouring according to a flux/TMP related algorithm; that is, employing the lowest air scouring rate possible so as to maintain a flux below the critical flux value. This type of control assumed a steady sludge concentration within the design limits (12-15 g/l), as opposed to the low solids concentration operation required at the start-up phase. For this reason, it was decided to re-program the SCADA control software so that it would allow for an additional operational mode with low MLSS, where the highest air scouring rate could be employed when [MLSS] in the MBR tanks was below a critical value of 8 g/l.

    Figure 9: MBR pumps at Arenales del Sol

    Also, during low or no inflow periods to the plant, the MBR would allow for intermittent aeration every 30 minutes to maintain aerobic conditions, avoiding sludge settling at the bottom of the tanks and between the membrane plates. When not in operation, all membrane lanes were aerated for 2.5 minutes every 25 minutes. During low inflow periods, the eight MBR lanes were operated alternatively in pairs.

    Finally, a submersible mixer was installed in each MBR lane not fitted with MBR modules (until second commissioning phase) to keep biomass in suspension, while a minimum 200% recirculation was maintained.

    Fouling control strategies during start-up: Polymer dosing

    To minimise potential fouling at initial low MLSS, it was also decided to dose a synthetic cationic polymer, (MPE 50, Nalco) designed to suppress membrane fouling. This product has shown good results in increasing critical flux at other existing MBRs worldwide at low temperatures, as per the MBR consultants’ experience, and also suppresses foaming. It was not possible at the time of commissioning to evaluate fully the beneficial effects of the addition of this polymer, since there was a simultaneous temperature increase in the sludge at the time of dosing (see graph).

    The dosage of MPE 50 was initiated at 4 g/l MLSS and was stopped shortly before reaching 9 g/l. The use of this product was considered, however, a viable option to reduce fouling – or enhance flux – and it was subsequently included in the plant’s O&M guidelines as an emergency strategy to improve plant’s overall performance during storm events, load changes or significant temperature decrease.

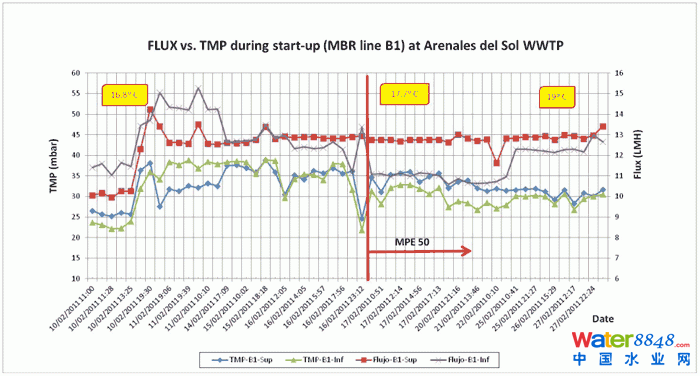

    Figure 10: Flux versus TMP during startup (MBR line B1) at Arenales del Sol WWTP

    Fouling control strategies during start-up: Foaming

    Foaming is a common issue in biotreatment processes and there are a large number of management strategies, yet these are not always put into practice. Historically, there have been many MBR plants installed without foaming removal or control systems in their designs which subsequently experienced problems during foaming events, with foam sometimes overflowing into the biological tanks.

    The occurrence of foam at start-up and operational stages differs both in its origin and also in its magnitude. The release of the hydrophilic agent the membranes are coated with for preservation during storage may cause a very light and clear foam, which disappears within hours once filtration conditions start. Another type of foaming that can happen at the same time is of biological origin and can arise from low temperatures, insufficient organic loads, a non-acclimatised biomass or excessive chemical cleanings.

    Foaming may be exacerbated when the biological process in the aerobic/anoxic tanks and the MBR is interrupted due to the typical PID and equipment adjustments that take place during start-up. As a result, extensive inactivation of micro-organisms will lead to foaming due to proteinaceous DNA release from dead cells. Finally, foaming occurrence during normal and stable operation of MBRs is also common due to the long SRTs, yet this foam type tends to be naturally controlled at large municipal plants as long as foam is not “trapped” in the reactor.

    At Arenales del Sol, foaming issues were taken into consideration when designing the biological tanks, ensuring that there was always an overflow from anoxic tanks through to the MBR chambers and into the recirculation chamber. Any foaming event eventually ends up at the MBR lanes, where an overflow weir directs all recirculating sludge (and foam) into a channel fitted with a simple foam removal system that operates with two manually operated gates. All foam removed is accumulated in a sump fitted with submersible pumps, from where it can then be sent to the sludge dewatering system, or back into the recirculation pipeline into the anoxic tanks.

    Conclusions

    The Arenales del Sol plant was, at the time of commissioning, under some of the typical pressures found in municipal WWTPs in coastal regions. There was an urgency to have the plant fully working at certain dates and there was no room for error in either the water quality to be provided or in reliance on the existing plant which could no longer provide efficient treatment.

    The previous MBR knowledge of the contractor, MBR system integrators and technical assistance ensured a rapid commissioning with minimal deviations from the planned schedule over a period of eight weeks. The whole WWTP was designed with a great amount of contingency equipment and fully orientated towards MBRs.

    The WEST modelling software was helpful in forecasting potential biological process pitfalls prior to the plant attaining design conditions and aided greatly in the planning of sludge seeding and biomass acclimatation. It also provided useful strategies for operation, as the software was also used to simulate different inflow scenarios throughout the year.

    Finally, a great deal of care and planning was put into the commissioning and start-up phases of the project, with various preventive fouling control techniques enforced with the sole aim of reducing plant downtime for maintenance cleaning and ensuring full flow treatment capability for the critical first few months.

    微信掃一掃關注中國水業網/>
</div>
<div   id=

    [ 行業資訊搜索 ]  [ ]  [ 打印本文 ]  [ 關閉窗口 ]

    0條 [查看全部]  相關評論

    推薦圖文
    吳迪   博士: 百年持續迭代,新型生物膜工藝在提質增效、督察常態化背景下的典型應用 直播時間:2024年6月20日(周四)14:00—16:00 2024-06-20 14:00:00 開始 Paul Westerhoff院士、王鵬教授等人領銜空氣取水學術與科技高端論壇 直播時間:2024年6月8日(周六)08:50 2024-06-08 08:50:00 開始
    報告題目:《湖南省排水系統溢流控制技術導則》解讀及相關技術探討  報告人簡介:  尹華升,男,教授級高級工程師,湖南省建筑科學研究院副總工程師、湖南省非開挖工程技術研究中心主任,湖南排水協會副秘書長; Water & Ecology Forum: 水與生態新起點 直播時間:2024年5月24日(周三)14:30 2024-05-24 14:30:00 開始
    中國水環境治理存在的問題及發展方向 直播時間:2024年5月28日(星期二)14:00—16:00 2024-05-28 14:00:00 開始 5月22日下午丨《城鎮排水管網系統診斷技術規程》宣貫會 直播時間:2024年5月22日(周三)14:00-16:00 2024-05-22 14:00:00 開始
    雙碳背景下污泥處置資源化路徑探索--杜炯  教授級高級工程師,上海市政工程設計研究總院(集團)有限公司第四設計院總工程師,注冊公用設備工程師、注冊咨詢工程師(投資),上海土木工程學會會員、復旦大學資源 JWPE 網絡報告/用于快速現場廢水監測的折紙微流體裝置 直播時間:2024年5月13日(星期一)19:00 2024-05-13 19:00:00 -楊竹根  英國克蘭菲爾德大學教授、高級傳感器實驗
    紫外光原位固化法管道修復全產業鏈質量控制倡議 直播時間:2024年5月7日(星期二)9:00-16:30 2024-05-07 09:00:00 開始 華北院 馬洪濤 副總工:系統化全域推進海綿城市建設的應與不應——海綿城市建設正反案例1 直播時間:2024年4月30日(周二)9:30 2024-04-30 09:30:00 開始
    高效納濾膜:中空纖維納濾膜的特點與應用 直播時間:2024年4月27日(周六)10:00-11:00 2024-04-27 10:00:00 開始-先進水技術博覽(Part 14) 聚力水務科技創新、中德研討推進行業高質量發展 ——特邀德國亞琛工業大學Max Dohman 直播時間:2024年4月14日(周日)15:00 2024-04-14 15:00:00 開始
    康碧熱水解高級厭氧消化的全球經驗和展望 | 北京排水集團高安屯再生水廠低碳運營實踐與探索 直播時間:2024年4月10日(周三)14:00—16:00 2024-04-10 14:00:00 開始 世界水日,與未來新水務在深圳約一個高峰論壇 直播時間:2024年3月22日(周五)08:30—17:30 2024-03-22 08:30:00 開始
    中國給水排水直播:直播時間:2024年3月14日(周四)14:00 2024-03-14 14:00:00 開始    題目:占地受限情況下的污水廠水質提升解決方案 主講人:程忠紅, 蘇伊士亞洲 高級 華北設計院:高密度建成區黑臭水體整治效果鞏固提升要點分析 直播時間:2024年3月4日(周一)9:30 2024-03-04 09:30:00 開始
    2月23日|2024年“云學堂科技學習周”暨第一屆粵港澳大灣區青年設計師技術交流與分享論壇 直播時間:2024年2月23日(星期五)9:00—17:00 2024-02-23 09:00:00 開始 2月22日|2024年“云學堂科技學習周”暨第一屆粵港澳大灣區青年設計師技術交流與分享論壇 直播時間:2024年2月22日(星期四)9:00—18:00 2024-02-22 09:00:00 開始
    2月21日|2024年“云學堂科技學習周”暨第一屆粵港澳大灣區青年設計師技術交流與分享論壇 直播時間:2024年2月21日(星期三)9:00—18:00 2024-02-21 09:00:00 開始 大灣區青年設計師論壇直播預告(第一屆粵港澳大灣區青年設計師技術交流論壇)  “醒年盹、學好習、開新篇”2024年“云學堂科技學習周”暨第一屆粵港澳大灣區青年設計師技術交流與分享論壇
    山東日照:“鄉村之腎”監管裝上“智慧芯”    日照市生態環境局農村辦負責人時培石介紹,農村生活污水處理系統被稱為“鄉村之腎”,對于農村水環境的改善發揮著重要作用 人工濕地國際大咖/西安理工大學趙亞乾教授:基于人工濕地技術的污水凈化之路 直播時間:2024年1月30日(星期二)19:00 2024-01-30 19:00:00 開始
    馬洪濤院長:城市黑臭水體治理與污水收集處理提質增效統籌推進的一些思考 直播時間:2024年1月25日 10:00 2024-01-25 10:00:00 開始 2024年水務春晚 直播時間:2024年1月18日(周四)18:00—22:00 2024-01-18 18:00:00 開始
    《以物聯網技術打造新型排水基礎設施》 直播時間:2024年1月11日(星期四)15:00 2024-01-11 15:00:00 開始--劉樹模,湖南清源華建環境科技有限公司董事長,清華大學碩士研究生 WPE網絡報告:作者-審稿-編輯視野下的高水平論文 直播時間:2024年1月10日(星期三)19:00 2024-01-10 19:00:00 開始
    核心期刊:中國給水排水》繼續入編北大《中文核心期刊要目總覽》 中國給水排水核心科技期刊 直播丨《城鎮供水管網漏損控制及評定標準》宣貫會 直播時間:2023年12月27日 09:30—11:00 2023-12-27 12:00:00 開始
    【直播】【第五屆水利學科發展前沿學術研討會】王浩院士:從流域視角看城市洪澇治理與海綿城市建設 先進水技術博覽(Part 13)|水回用安全保障的高效監測技術
    中國城鎮供水排水協會城鎮水環境專業委員會2023年年會暨換屆大會 直播時間:2023年12月16日(周六)08:30—18:00 2023-12-16 08:30:00 開始 第二屆歐洲華人生態與環境青年學者論壇-水環境專題 直播時間:2023年12月9日(周六)16:00—24:00 2023-12-09 16:00:00 開始
    JWPE網絡報告:綜述論文寫作的一點體會 直播時間:2023年11月30日(星期四)19:00 2023-11-30 19:00:00 開始 WaterInsight第9期丨強志民研究員:紫外線水消毒技術 再生水
    水域生態學高端論壇(2023)熱帶亞熱帶水生態工程教育部工程研究中心技術委員會會議 直播時間:2023年11月29日(周三) 09:00—17:40 2023-11-29 09:00:00 開始 中國給水排水直播:智慧水務與科技創新高峰論壇 直播時間:2023年11月25日(周六) 13:30 2023-11-25 13:30:00 開始
    中國水協團體標準《城鎮污水資源與能源回收利用技術規程》宣貫會通知 中國城鎮供水排水協會 2023年11月14日9:00線上舉行直播/JWPE網絡報告:提高飲用水安全性:應對新的影響并識別重要的毒性因素
    直播主題:“對癥下藥”解決工業園區污水處理難題   報告人:陳智  蘇伊士亞洲 技術推廣經理 直播時間:2023年11月2日(周四)14:00—16:00 2023-11-02 14:00:00 開始 10月29日·上海|市政環境治理與水環境可持續發展論壇
    BEST第十五期|徐祖信 院士 :長江水環境治理關鍵      直播時間:2023年10月26日(周四)20:00—22:00 2023-10-26 20:00:00 開始 《水工藝工程雜志》系列網絡報告|學術論文寫作之我見 直播時間:2023年10月19日(周四)19:00 2023-10-19 19:00:00 開始
    污水處理廠污泥減量技術研討會 直播時間:2023年10月20日13:30-17:30 2023-10-20 13:30:00 開始 技術沙龍 | 先進水技術博覽(Part 12) 直播時間:10月14日(周六)上午10:00-12:00 2023-10-14 10:00:00 開始
    直播題目:蘇伊士污泥焚燒及零碳足跡概念污泥廠 主講人:程忠紅 蘇伊士亞洲 技術推廣經理  內容包括: 1.	SUEZ污泥業務產品介紹 2.	全球不同焚燒項目介紹 3.	上海浦東污泥焚燒項目及運營情況 中國給水排水第十四屆中國污泥千人大會參觀項目之一:上海浦東新區污水廠污泥處理處置工程
    《水工藝工程雜志》系列網絡報告 直播時間:2023年9月26日 16:00  王曉昌  愛思唯爾期刊《水工藝工程雜志》(Journal of Water Process Engineering)共同主 中國給水排水2024年污水處理廠提標改造(污水處理提質增效)高級研討會(第八屆)邀請函暨征稿啟事  同期召開中國給水排水2024年排水管網大會  (水環境綜合治理)  同期召開中國給水排水 2024年
    海綿城市標準化產業化建設的關鍵內容 結合項目案例,詳細介紹海綿城市建設的目標、技術體系及標準體系,探討關鍵技術標準化產業化建設的路徑,提出我國海綿城市建設的發展方向。 報告題目:《城鎮智慧水務技術指南》   中國給水排水直播平臺: 主講人簡介:  簡德武,教授級高級工程師,現任中國市政工程中南設計研究總院黨委委員、副院長,總院技術委員會副主任委員、信息技術委員會副主
    第一輪通知 | 國際水協第18屆可持續污泥技術與管理會議 主辦單位:國際水協,中國科學院  聯合主辦單位:《中國給水排水》雜志社 等 技術沙龍 | 先進水技術博覽(Part 11) 直播時間:8月19日(周六)上午10:00-12:00 2023-08-19 10:00:00  廣東匯祥環境科技有限公司  湛蛟  技術總監  天津萬
    中國水業院士論壇-中國給水排水直播平臺(微信公眾號cnww1985):自然—社會水循環與水安全學術研討會 WaterInsight第7期丨掀浪:高鐵酸鉀氧化技術的機理新認知及應用 直播時間:2023年8月5日(周六)上午10:00-11:00 2023-08-05 10:00:00 開始
    直播:“一泓清水入黃河”之山西省再生水產業化發展專題講座 直播時間:2023年7月23日(周日 )08:00-12:00 2023-07-23 08:00:00 開始 珊氮自養反硝化深度脫氮技術推介會 直播時間:2023年7月21日(周五)
    歐仁環境顛覆性技術:污水廠擴容“加速跑”(原有設施不動,污水處理規模擴容1倍!出水水質達地表水準IV類標準!),推動污水治理提質增效。  誠征全國各地污水廠提標擴容工程需求方(水務集團、BOT公司、設 直播預告|JWPE網絡報告:自然系統中難降解污染物去除的物化與生化作用及水回用安全保障 中國給水排水
    直播題目: 高排放標準下污水中難降解COD的去除技術     報告人:蘇伊士亞洲 技術推廣經理 程忠紅 WaterTalk|王凱軍:未來新水務 一起向未來  For and Beyond Water 中國環境科學學會水處理與回用專業委員會以網絡會議形式舉辦“水與發展縱論”(WaterTalk)系列學術報
    5月18日下午 14:00—16:00 直播  題目: 高密度沉淀池技術的迭代更新 主講人: 程忠紅 蘇伊士亞洲 技術推廣經理  大綱:  高密池技術原理 不同型號高密池的差異和應用區別 高密池與其他 BEST|綠色低碳科技前沿與創新發展--中國工程院院士高翔教授  直播時間:2023年4月30日 14:00—16:00 2023-04-30 14:00:00 開始
    日照:“碳”尋鄉村振興“綠色密碼”  鳳凰網山東    鄉村生態宜居,鄉村振興的底色才會更亮。我市堅持鄉村建設與后續管護并重,市、區、鎮聯 BEST論壇講座報告第十三期(cnwww1985):全球碳預算和未來全球碳循環的不穩定性風險 The global carbon budget and risks of futur
    國際水協IWA 3月17日直播:3月17日 國際水協IWA創新項目獎PIA獲獎項目介紹分享會 直播時間:2023年3月17日 9:00—11:30 2023-03-17 09:00:00 開始 中國給水排水直播:云中漫步-融合大數據、人工智能及云計算的威立雅智慧水務系統Hubgrade 直播時間:2023年3月15日
    中國給水排水直播平臺會議通知 | 2023污泥處理處置技術與應用高峰論壇(清華大學王凱軍教授團隊等) 中國污水千人大會參觀項目之一: 云南合續環境科技股份有限公司  ?谑形鞅捞端|凈化中心
    中國給水排水 Water Insight直播:劉銳平  清華大學 環境學院 教授 博士生導師—高濃度硝酸鹽廢水反硝化脫氮過程強化原理與應用 會議時間:2023.1.7(周六)10:00—11:00 智慧水務的工程全生命周期實踐分享 直播時間:2023年1月6日 15:00-16:00 對話嘉賓:竇秋萍  華霖富水利環境技術咨詢(上海)有限公司  總經理 主持人:李德橋   歐特克軟件(中國)有限
    蘇伊士 直播時間:12月30日14:00-16:00直播題目:污泥處理處置的“因地制宜和因泥制宜” 主講人:程忠紅,蘇伊士亞洲  技術推廣經理 特邀嘉賓:劉波 中國市政工程西南設計研究總院二院總工 教 蘇伊士 直播時間:12月27日14:00-16:00;復雜原水水質下的飲用水解決方案    陳智,蘇伊士亞洲,技術推廣經理,畢業于香港科技大學土木與環境工程系,熟悉市政及工業的給水及污水處理,對蘇伊士
    曲久輝  中國工程院院士,美國國家工程院外籍院士,發展中國家科學院院士;清華大學環境學院特聘教授、博士生導師;中國科學院生態環境研究中心研究員 基于模擬仿真的污水處理廠數字化與智慧化:現狀與未來 直播時間:2022年12月28日(周三)9:30—12:00
    2022城鎮溢流污染控制高峰論壇|聚焦雨季溢流污染控制的技術應用與推廣 中國給水排水 王愛杰 哈爾濱工業大學教授,國家杰青,長江學者,國家 領軍人才:廣州大學學術講座|低碳水質凈化技術及實踐 直播時間:2022年12月18日 9:30
    國際水協會哥本哈根世界水大會成果分享系列網絡會議 直播時間:2022年12月15日 20:00—22:00 德國專場直播主題:2022 中國沼氣學術年會暨中德沼氣合作論壇 2022 中國沼氣學術年會暨中德沼氣合作論壇德國專場 時間:2022年12月20日  下午 15:00—17:00(北京時間)
    2022中國沼氣學會學術年會暨第十二屆中德沼氣合作論壇的主論壇將于12月15日下午2點召開 技術交流 | 德國污水處理廠 計算系列規程使用介紹 城建水業
    WaterInsight首期丨王志偉教授:膜法水處理技術面臨的機遇與挑戰 直播時間:2022年12月10日 10:00—11:00 處理工藝專場|水業大講堂之六——城市供水直飲安全和智慧提質 直播時間:2022年12月8日 8:30—12:15
    建設管理專場|水業大講堂之六——城市供水直飲安全和智慧提質 直播時間:2022年12月7日 14:00—17:15 國際水協會哥本哈根世界水大會成果分享系列網絡會議 直播時間:2022年12月8日 20:00—22:00
    Training Course for Advanced Research & Development of Constructed Wetland Wastewater Treatment Tech 12月3日|2022IWA中國漏損控制高峰論壇 直播時間:2022年12月3日(周六)9:00—17:00 2022-12-03 09:00:00 開始
    國際水協會哥本哈根世界水大會成果分享系列網絡會議(第八期) 直播時間:2022年12月1日 20:00—22:00 2022-12-01 20:00:00 開始 中國給水排水直播:智慧輸配專場|水業大講堂之六——城市供水直飲安全和智慧提質 直播時間:2022年11月30日 14:00—17:05 2022-11-30 14:00:00 開始
    國際水協會哥本哈根世界水大會成果分享系列網絡會議(第七期) 直播時間:2022年11月25日 20:00—22:00 2022-11-25 20:00:00 開始 國標圖集22HM001-1《海綿城市建設設計示例(一)》首次宣貫會   直播時間:2022年11月24日 13:30—17:30
    中國給水排水直播平臺 【 李玉友,日本國立東北大學工學院土木與環境工程系教授,博導,注冊工程師】顆粒污泥工藝的研究和應用:從UASB到新型高效脫氮和磷回收 中國建科成立70周年|市政基礎設施綠色低碳發展高峰論壇   直播時間:2022年11月22日 13:30—18:25   2022-11-22 13:30:00 開始
    國際水協會哥本哈根世界水大會成果分享系列網絡會議(第六期)   直播時間:2022年11月22日 20:00—22:00 會議預告| 國際水協會哥本哈根世界水大會成果分享系列網絡會議(第五期) 中國給水排水
    奮進七十載 起航新征程|中國市政華北院第十屆科技工作會議暨慶祝建院七十周年大會  直播時間:2022年11月18日 9:30   2022-11-18 09:00:00 開始 樊明遠:中國城市水業的效率和服務要做一個規范     樊明遠 世界銀行高級工程師
    黃綿松  北京首創生態環保集團股份有限公司智慧環保事業部總經理,正高級工程師  獲清華大學博士學位:海綿城市系統化運維的挑戰與實踐  直播時間:2022年11月16日 18:30  黃綿松  北京 全國節水高新技術成果展云端活動周尋水路  污水回用專場      轉發直播贈送  中國給水排水電子期刊  !!  直播抽獎 100份 中國給水排水電子期刊  。!
    首屆全國節水高新技術成果展即將開幕,同步舉行的節水時光云端活動周”也將于2022年11月15日10:00-12:00 、14:30-17:00,在云端與水務行業的專家朋友見面!    在這即將到來激動 會議預告| 國際水協會哥本哈根世界水大會成果分享系列網絡會議(第四期) 中國給水排水
    推薦行業資訊
    點擊排行

    主站蜘蛛池模板: 昭觉县| 河东区| 永善县| 彭山县| 云浮市| 交城县| 越西县| 淳化县| 颍上县| 德保县| 青河县| 乌拉特后旗| 鄂温| 泽库县| 航空| 鲜城| 佛坪县| 红河县| 普宁市| 耒阳市| 田阳县| 西峡县| 和林格尔县| 时尚| 兴文县| 沂水县| 永靖县| 湘阴县| 如皋市| 花莲市| 宁都县| 襄汾县| 北碚区| 西青区| 顺昌县| 理塘县| 临猗县| 安达市| 陆丰市| 达孜县| 若羌县|
